Apparel Production Timeline: From First Inquiry to Delivery

May 27, 2026 · By the Surge Clothings Team

Typical Total Timeline

2–3 wks

Sampling

3–5 wks

Production

3–5 days

QC & Finishing

18–28 days

Sea Freight

* First-time orders run longer due to development cycles. Repeat orders on approved styles move faster.

One of the first questions US brands ask us is: how long will this actually take? It's a fair question, and the honest answer is that it depends on where you are in the development cycle. A brand placing a repeat order on an approved style has a very different timeline from one still finalizing its tech pack.

What follows is a stage-by-stage breakdown of how a production run moves from initial inquiry through to goods arriving at your US warehouse — with realistic timeframes at each step.

Stage 1: Inquiry & Quotation (3–5 Business Days)

Design and sourcing team reviewing tech packs

Our team reviews tech packs and fabric specs before generating a quote.

The process begins when you send us your tech pack, design references, and target quantity. From there, our team works through three parallel tracks:

  • Fabric sourcing: We identify fabric options in our Guangzhou supply chain and pull swatches if needed. For performance fabrics — polyester blends, spandex, moisture-wicking jersey — we typically have direct relationships with the mills that supply them.
  • Construction review: We flag any construction details that may affect cost or feasibility — particularly for technical garments with bonded seams, YKK hardware, or specialty trims.
  • FOB quotation: We return a line-item quote with FOB Guangzhou pricing, lead time estimate, and MOQ. For new clients, we also include notes on any spec adjustments we'd recommend before sampling.

This stage typically takes 3–5 business days. Complex styles with multiple fabrications or specialty trims may take a day or two longer.

Stage 2: Sampling (2–3 Weeks)

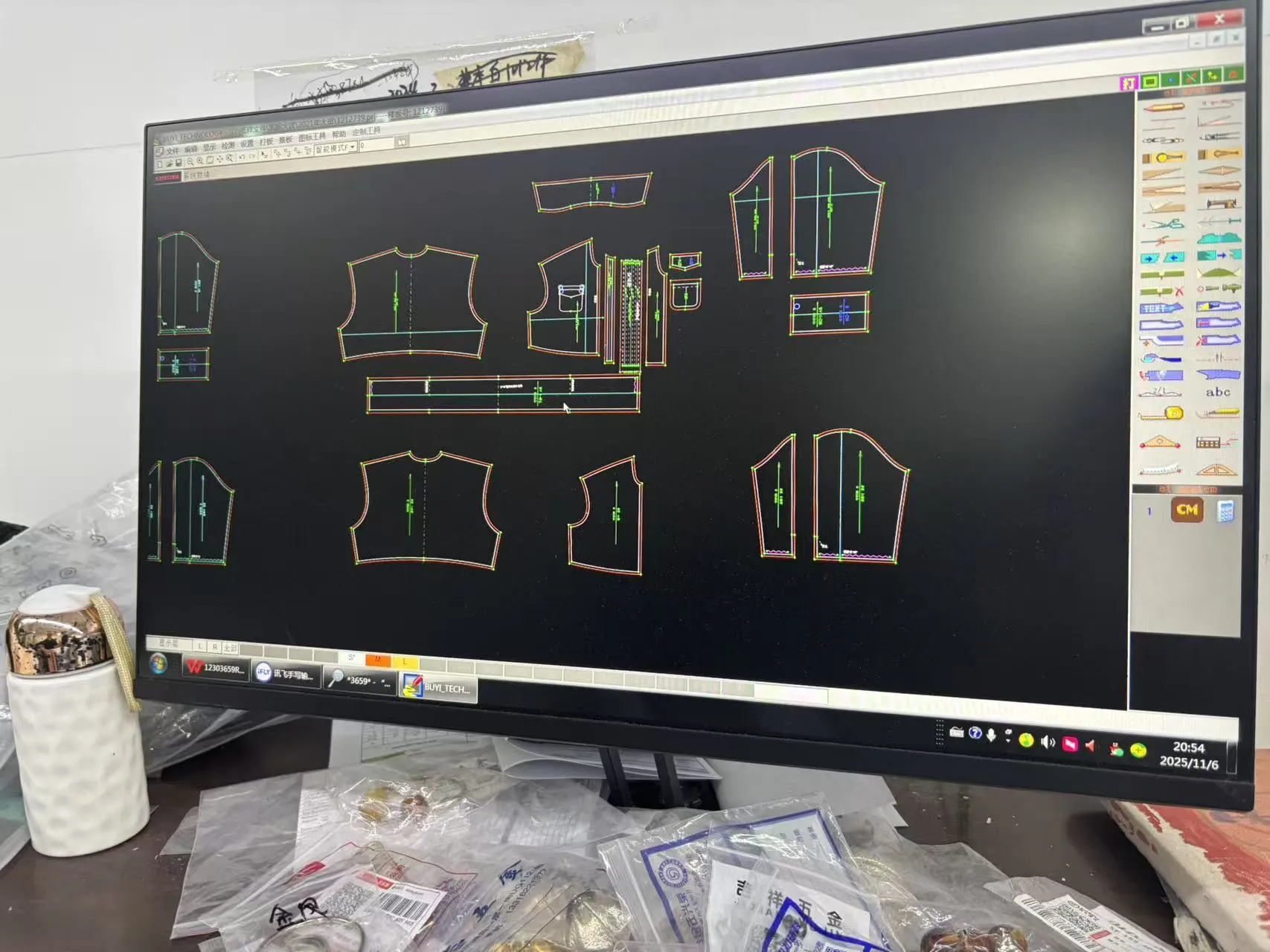

Pattern making for apparel sample

Pattern development is one of the most time-intensive steps in the sampling stage.

Once you approve the quote and submit a sampling deposit, the sample development process begins. For a standard garment, this involves:

  • Pattern making (3–5 days): Our pattern team drafts from your tech pack. We flag any ambiguities before cutting — unclear seam allowances, missing grading specs, or conflicting measurements are the most common issues at this stage.
  • Sample cutting and sewing (4–7 days): The first sample is cut and sewn. For styles requiring specialty trims or hardware, lead time for those components is often the binding constraint.
  • Internal QC and photos (1–2 days): Before shipping, we photograph the sample against your spec sheet and flag any deviations proactively.

The sample ships via DHL or FedEx express (3–5 days to most US cities). Round-trip from sample dispatch to your feedback typically takes about a week if you turn around comments promptly.

Most styles require one round of revisions. Technically complex styles — bonded seams, structured outerwear, multi-panel activewear — may need a second round. We always recommend budgeting time for at least one revision cycle before locking the production order.

Stage 3: Production (3–5 Weeks)

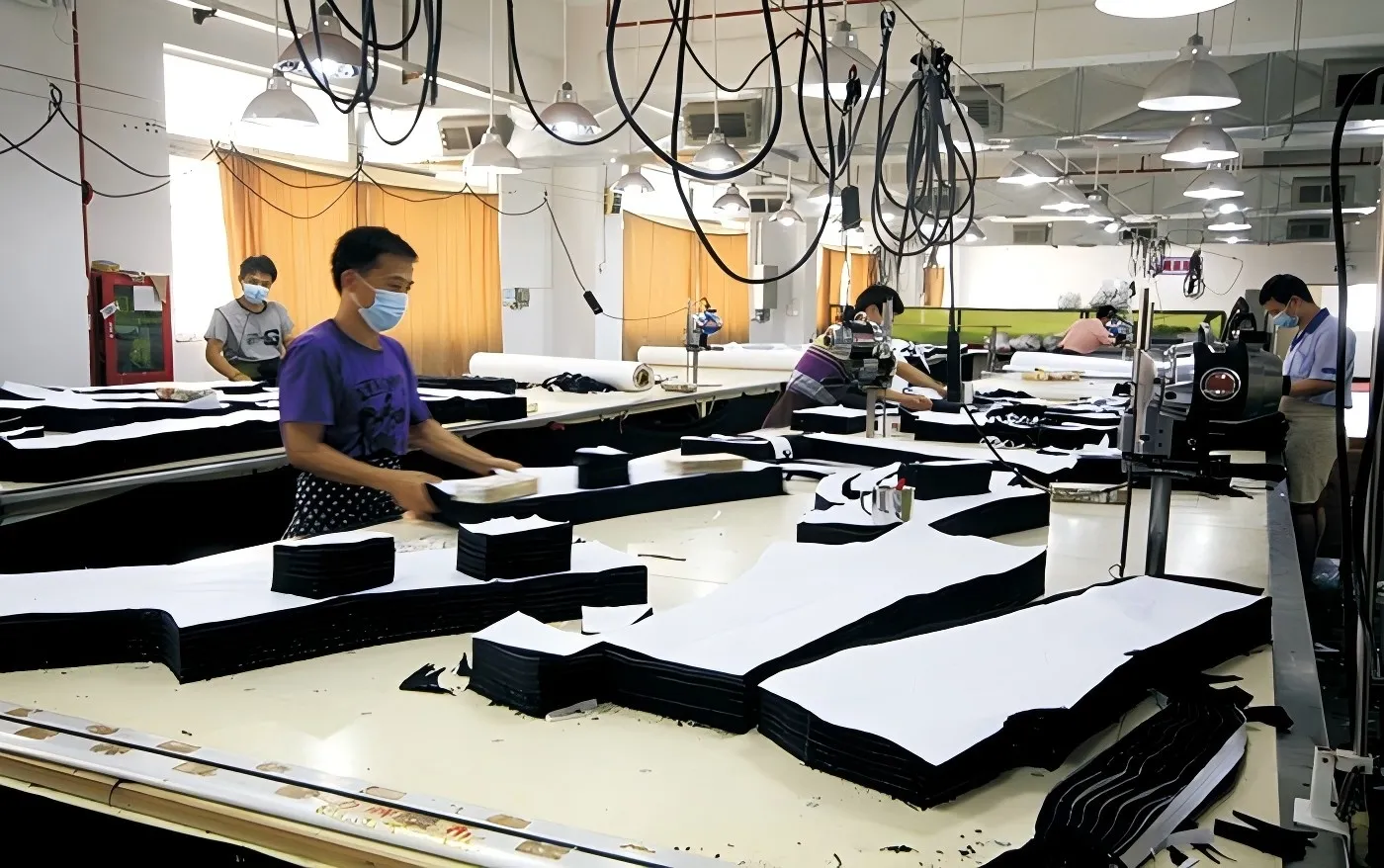

Fabric cutting in the production facility

Bulk fabric cutting marks the start of the production run.

Once the sample is approved and you've placed a production deposit, we order bulk fabric and begin production scheduling. This stage has three key phases:

Fabric procurement (5–10 days).

For fabrics held in stock at our Guangzhou suppliers, lead time is typically 3–5 days. Custom dyeing, prints, or specialty mills can add another 5–7 days. This is one of the most variable parts of the timeline — brands sourcing unusual fabrics should factor in a buffer here.

Production run (2–4 weeks).

Actual cut-and-sew time depends on the complexity of the style and the total unit count. A 300-piece order of a single-panel T-shirt moves faster than a 300-piece order of a bonded jacket with 8 panels and contrast piping. We provide a production schedule at the start of this stage so you can plan around delivery.

Trims and finishing (3–5 days).

Labels, hangtags, packaging inserts, and poly bags are applied at the end of production. For brands with custom branded packaging, have your files ready to send at sample approval — printing takes time and is often on the critical path.

Stage 4: Quality Control (3–5 Days)

Before goods are packed for shipment, our QC team conducts a final inspection. The scope depends on what was agreed in your production order, but a standard inspection covers:

  • Measurements against your approved spec sheet (key dimensions on 10–20% of units)
  • Visual inspection for defects: loose threads, skipped stitches, uneven seams, fabric flaws
  • Label placement, trim accuracy, and packaging compliance
  • Color consistency across the run, particularly for dyed or printed fabrics

We provide a QC report with photos before releasing goods for shipment. For brands that require third-party inspection (SGS, Bureau Veritas), we coordinate scheduling — add 3–5 days for third-party inspection depending on availability. Our quality control process is documented in more detail on our services page.

Stage 5: Shipping & Customs (18–35 Days)

Finished garments packed for export

Goods are carton-packed and labeled for ocean freight or air consolidation.

Once QC is passed and the balance payment is received, goods are packed and released to the freight forwarder. Typical lead times from Guangzhou:

  • Sea freight LCL (Less Than Container Load): 18–28 days port-to-port (Guangzhou/Yantian to Los Angeles or Long Beach). Add 5–10 days for US customs clearance and inland delivery.
  • Sea freight FCL (Full Container Load): Similar transit time, but more predictable scheduling. Typically used for orders above 500 CBM.
  • Air freight: 5–7 days transit. Significantly higher cost — typically only used for samples, urgent restocks, or very small orders. Not practical for full production runs given tariff exposure on declared FOB value.

We coordinate with freight forwarders on your behalf and can recommend customs brokers familiar with HTS chapters 61–62 apparel classifications. Proper HTS classification matters — misclassification delays clearance and can result in penalties.

The Full Picture: A Realistic Planning Calendar

Combining all stages, here's what a realistic first-order timeline looks like for a new US brand placing a production order with us:

StageDuration
Inquiry & Quote3–5 days
Sample Development2–3 weeks
Production3–5 weeks
QC & Packing3–5 days
Sea Freight (LCL)18–28 days
Total (typical)10–15 weeks

The most common source of delays isn't the factory — it's the back-and-forth during sampling. Brands that arrive with complete tech packs, clear grading specs, and prompt sample feedback consistently hit the faster end of the range. Brands that are still finalizing design decisions mid-sample add weeks.

If you're working to a specific delivery deadline — a trade show, a launch date, a seasonal window — share that target at the start. We'll work backwards from it and flag early if the timeline is at risk.

Ready to get started? Our full production packages cover everything from tech pack review through to delivery coordination. Send us your project details and we'll come back to you with a production schedule built around your timeline.

Have a production deadline to hit?

Let's build a schedule around your launch date.
